Project Economics

CAPITAL COST ESTIMATE (CAPEX)

The following presents separate summaries of the Initial CAPEX, and Sustaining CAPEX as estimated in the PEA (1) distributed over the life-of- mine (LoM) with the two indicated categories of capital then totaled. Owner’s costs, contingencies and risk amounts are included in this CAPEX.

Capital Cost Summary



Area



Description

Initial
CAPEX
(US$M)

Sustaining
CAPEX
(US$M)

Total
(US$M)

Mine

Equipment lease payments

13.4

55.3

68.7

Mine

Shops and Other Surface Infrastructure

8

0

8

Mill

Processing Capital

120.7

9.6

130.2

G&A

Dewatering Capital

9.9

5.6

15.5

G&A

Royalty Purchase Option

1

0

1

Indirects

Mine Indirect, First Fills, & Owners Costs

5.2

0

5.2

Indirects

Process Plant Indirect, First Fills, & Owners Costs

11.1

0

11.1

Indirects

Engineering, Procurement & Construction Management (EPCM)

17.2

0

17.2

Indirects

Mine Contingency (12% of total* directs and indirects)

10

0

10

Indirects

Process Plant Contingency (15% of total** directs and indirects)

23.4

0

23.4



Total Major Area CAPEX

219.9

70.5

290.4

Other

Working Capital

22.2

-22.2

0

Other

Surety Bond Premium

0.4

OPEX G&A

0.4

Other

Reclamation Bond Restricted Cash Collateral

4.6

-5.5

-0.9

Other

Project Closure and Rehabilitation

0

12

12

Other

Equipment Salvage Value

0

-16.2

-16.2



Total CAPEX

247.1

38.6

285.7

Notes:

  1. *Mine Contingency reflective of 10% applied to budgetary priced CAT equipment and 30% applied to non-quoted equipment and infrastructure.
  2. **Mill contingency applied to total capital including initial and Sustaining Capital
  3. Numbers may not sum precisely due to rounding.
  4. M = Million


The capital is representative of a mine mobile equipment lease for the loaders, haul trucks, production drills, and auxiliary equipment.

The CAPEX is based on the following key assumptions:

  • All relevant permits in a timely manner to meet the Project schedule.
  • Quotes from Vendors for leasing equipment to be valid for budget purposes.
  • Suitable backfill material is available locally. Soil conditions are adequate for foundation bearing pressures.
  • Engineering and Construction activities will be carried out in a continuous program with full funding available, including contingency.
  • Bulk materials such as cement, rebar, structural steel and plate, cable, cable tray, and piping are all readily available in the scheduled timeframe.
  • Capital equipment is available in the timeframe shown.
  • The construction and commissioning period begins upon receipt of construction permit, including Open Pit stripping, process plant, and infrastructure development.
  • The production plan assumes the mill is immediately constructed and available at full capacity 2000 tpd for 365 days per year throughout the Life-of-Mine Plan (LoMP).

OPERATING COST ESTIMATE (OPEX)

A summary of the overall life-of-mine project OPEX is follows. The OPEX costs presented in the table exclude pre-production OPEX allowances for mining, process and G&A. The unit costs shown are based on 23.6 million tonnes (Mt) of mineralized material mined and processed (Table 1.4).

Table 1.3: OPEX by Major Area



Area

LoM Total
OPEX
(US$M)

OPEX per
Total Tonne
Mined

OPEX per
Tonne Mill
Feed

OPEX per
Tonne Heap
Leach Feed

Average
OPEX
(US$/t processed)

Mining

$227.90

$1.95





$9.67

Mill

$74.20



$16.43



$3.15

Heap Leach

$130.30





$6.62

$5.53

Dewatering

$6.50







$0.28

G&A

$31.60







$1.34

Total OPEX

$470.50







19.97

Notes: Numbers may not sum precisely due to rounding.

ECONOMIC ANALYSIS

The results of the economic analysis contain forward-looking information under Canadian securities law. The results rely on inputs that are subject to known and unknown risks, uncertainties, and other factors, which may cause actual results to differ materially from those presented here.

At assumed long-term prices for Au of US$2,400/oz and for Ag of US$27.70/oz, the financial results indicate a positive post-tax NPV at 5% of US$111.6M, an after-tax Internal Rate of Return (IRR) of 17.6% and a payback period of 3.6 years

The economic analysis is based on the discounted cash flow (DCF) method on a pre-tax and after-tax basis. The key metrics determined in the analysis are the NPV at a discount rate of 5%, the IRR, and the Payback Period. For the purposes of the evaluation, it is assumed that the operations are established within a single corporate entity. The Project has been evaluated on an unlevered, all-equity basis.

The cash flow model uses inputs from all elements of the Project to provide a comprehensive financial projection for the entire Project, on an annual basis, supporting an 8-year life of the Project with 7-year mining and milling period. Heap leach extends into year 8 to recover the residual leachate material. Years 8 to 10 use on-hand mining equipment to facilitate closure. All prices and costs are in US dollars and accurate as of Q2 2025. No provisions have been made for the effects of inflation.

Economic Analysis Parameters

Description

Unit

Value

Macroeconomic Parameters

Au Price

US$/oz

2,400.00

Ag Price

US$/oz

27.70

Discount Rate

%

5

Project Parameters

Mine Life

years

7

Mineable Mineral Resource (LoM)

Mt

23.6

Au Grade Mined (LoM Average)

g/t Au

0.63

Ag Grade Mined (LoM Average)

g/t Ag

2.42

Peak Mill Throughput

tpa

730,000

Mill Feed Grade (LoM Average)

g/t Au

1.75

Peak Heap Leach Throughput

tpa

2,920,000

Heap Leach Feed Grade (LoM Average)

g/t Au

0.37

Recoveries

%



Au Mill Argillite

%

95

Au Mill Volcanics

%

90

Au Heap Leach Argillite

%

75

Au Heap Leach Volcanics

%

75

Ag Mill Argillite

%

36

Ag Mill Volcanics

%

38

Ag Heap Leach Argillite

%

12

Ag Heap Leach Volcanics

%

16.5

Heap Leach Delay to Next Year

%

13

Au Payability (LoM average)

%

99.9

Ag Payability (LoM Average)

%

98

Total Au Produced (LoM)

koz

404.1

Total Ag Produced (LoM)

koz

354.5

Average Annual Au Production (LoM)

oz

57,201

Average Annual Au Production (first five years)

oz

63,893

Treatment Charge - Au

$/oz

2

Treatment Charge - Ag

$/oz

0

Royalty – Au and Ag (NSR)

%

1

Capital Cost Estimate

Initial Capital

(direct + indirect + contingencies)

US$ M

247

Sustaining Capital (LoM)

US$ M

27

Closure Costs

US$ M

12

LoM Operating Unit Costs

Mining

US$ per tonne processed

9.67

Processing Mill

US$ per tonne processed

3.15

Processing Heap Leach

US$ per tonne processed

5.53

Dewatering

US$ per tonne processed

0.28

General & Administrative

US$ per tonne processed

1.34

Total OPEX

US$ per tonne processed

19.97

LoM Average All-in Sustaining Cost1

US$/oz Au

1,269

Notes:

  1. All-in sustaining costs are a non-GAAP (Generally Accepted Accounting Principles) financial measure or ratio that have no standardized meaning under International Financial Reporting Standards Accounting Standards (IFRS) and may not be comparable to similar measures used by other issuers. As the Project is not in production, Viva does not have historical non-GAAP financial measures nor historical comparable measures under IFRS, and therefore the foregoing prospective non-GAAP financial measures or ratios may not be reconciled to the nearest comparable measures under IFRS.
  2. oz = troy ounce, koz = kilotroy ounce (1000 ounces), M = million, Mt = million tonnes, tpa = tonnes per annum
  3. Numbers may not sum precisely due to rounding


The cashflow analysis results in the following pre-tax and after-tax metrics in Table 1.5.

Project Cash Flow Analysis Summary

Description

Unit

Pre-Tax

Post-Tax

NPV @ 5%

US$ M

138.6

111.6

IRR

%

20.6

17.6

Payback Period

Years

3.3

3.6

Notes: M = million


Sensitivity analyses were conducted, using the cashflow analysis as the base case, to assess the impact of changes in metal prices, CAPEX, and OPEX on the Project’s NPV (5% discount rate) and IRR. The impact of each variable is examined individually with an interval of 40% and increments of 10% applied. It is to be noted that margin of error for cost estimates at the PEA study is typically -50% +50% while KCA states their estimate is +/-35% level of accuracy.

The post-tax results of the sensitivity analysis are shown in the following Figures. The NPV of the project is most sensitive to changes in the metal prices and OPEX, while the IRR is most sensitive to changes in the metal prices and CAPEX.

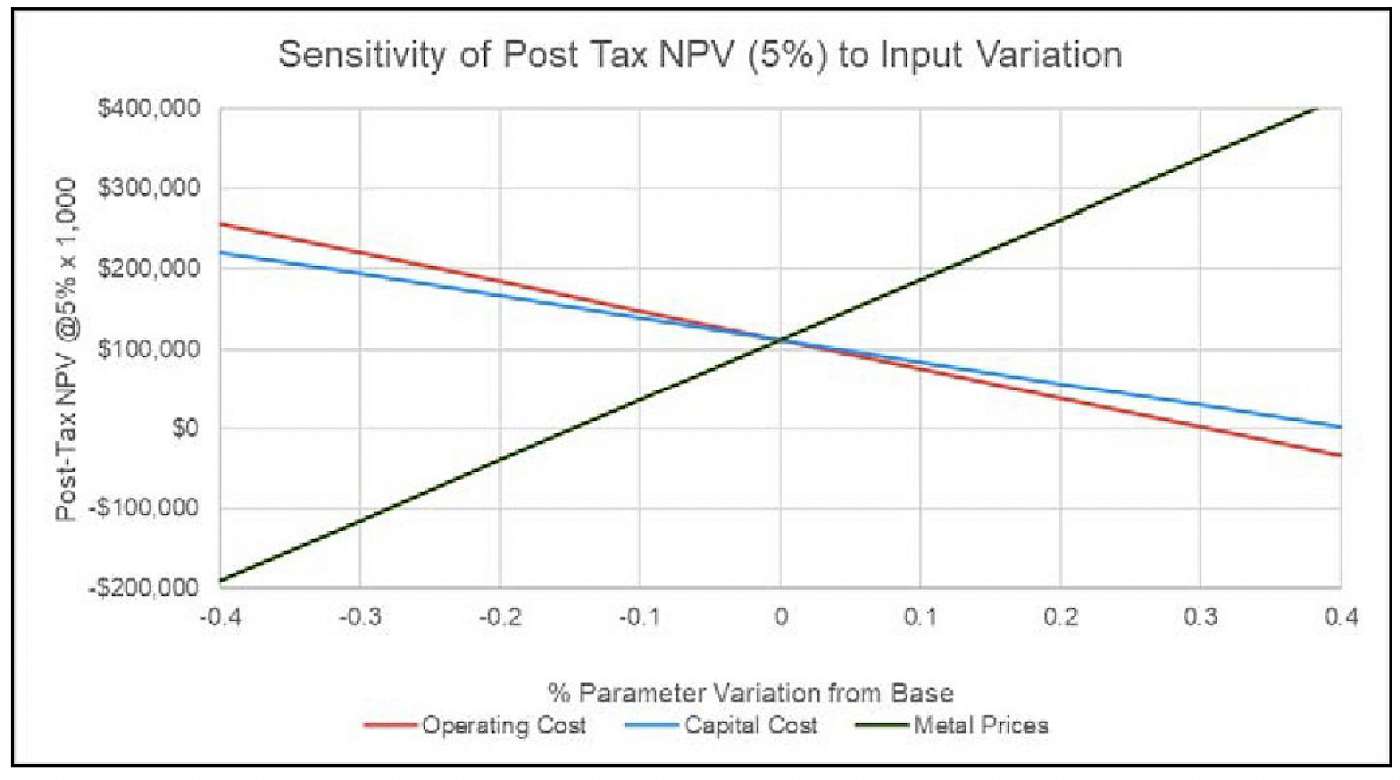

Post-Tax NPV (5%): Sensitivity to OPEX, CAPEX and Metal Prices

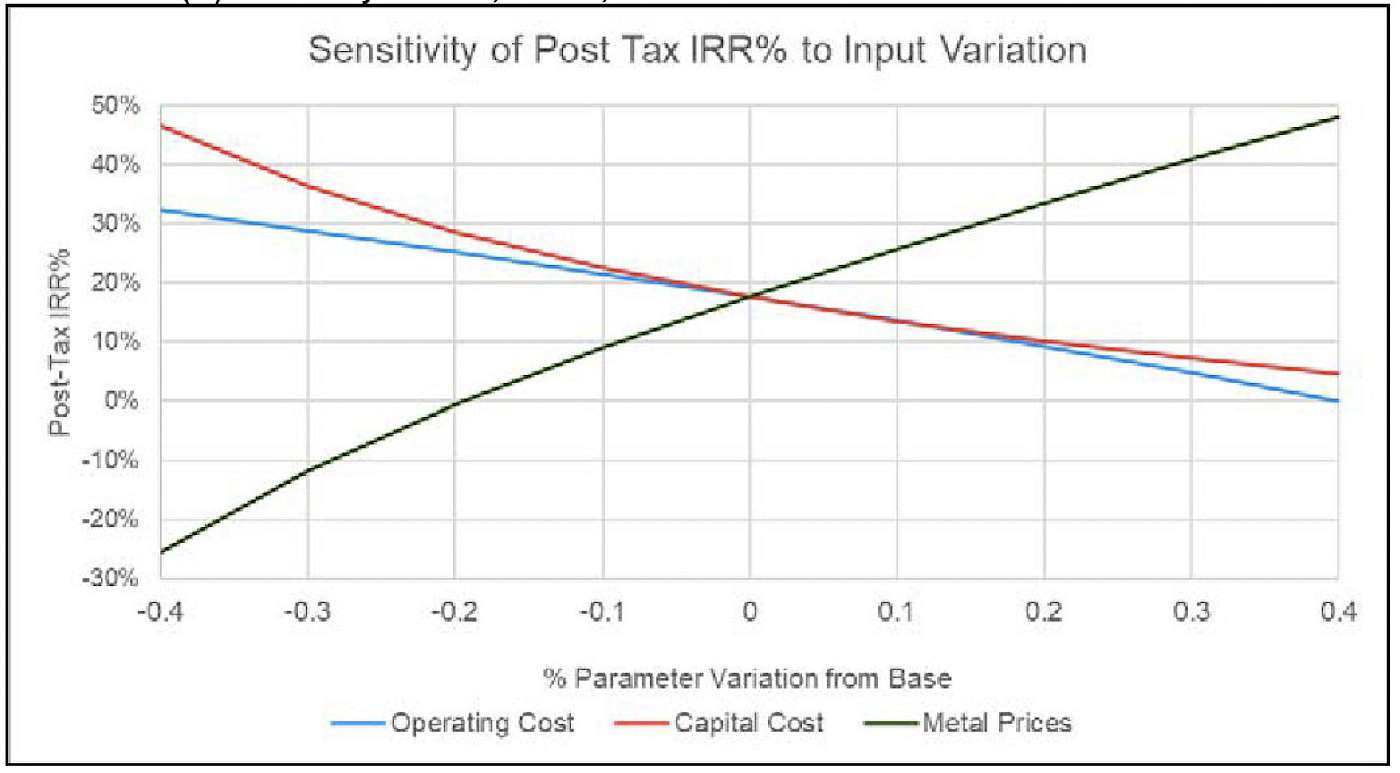

Post-Tax IRR (%): Sensitivity to OPEX, CAPEX, and Metal Prices


Economic Metrics Sensitivity to Variations in Au Price

Au Price
(US$
Post-Tax NPV 5%
(USSM)
Post-Tax IRR
(%)

1,920

(38.4)

-0.4

2,160

36.7

9.0

2,400

111.6

17.6

2,640

186.5

25.7

2,880

261.3

33.3

3,120

336.1

40.7

3,360

411.0

47.9


Note: Information summarized from Preliminary Economic Assessment NI 43-101 Technical Report, Tonopah Gold Project, Nevada, USA dated August 20, 2025, and filed on SEDAR August 21, 2025.
